Projects

Widening A27 Houten – Hooipolder

Houten – Breda, Netherlands
Project duration:  2024 – 2032
For the widening of the A27 between Houten and Breda, extensive monitoring was carried out to quantify soil settlement and long-term residual deformation over a twenty-year horizon. The same monitoring system also tracked the Merwede Bridge in Gorinchem and a high-pressure water pipeline. This integrated network delivered continuous, consistent measurements across all critical infrastructure elements.

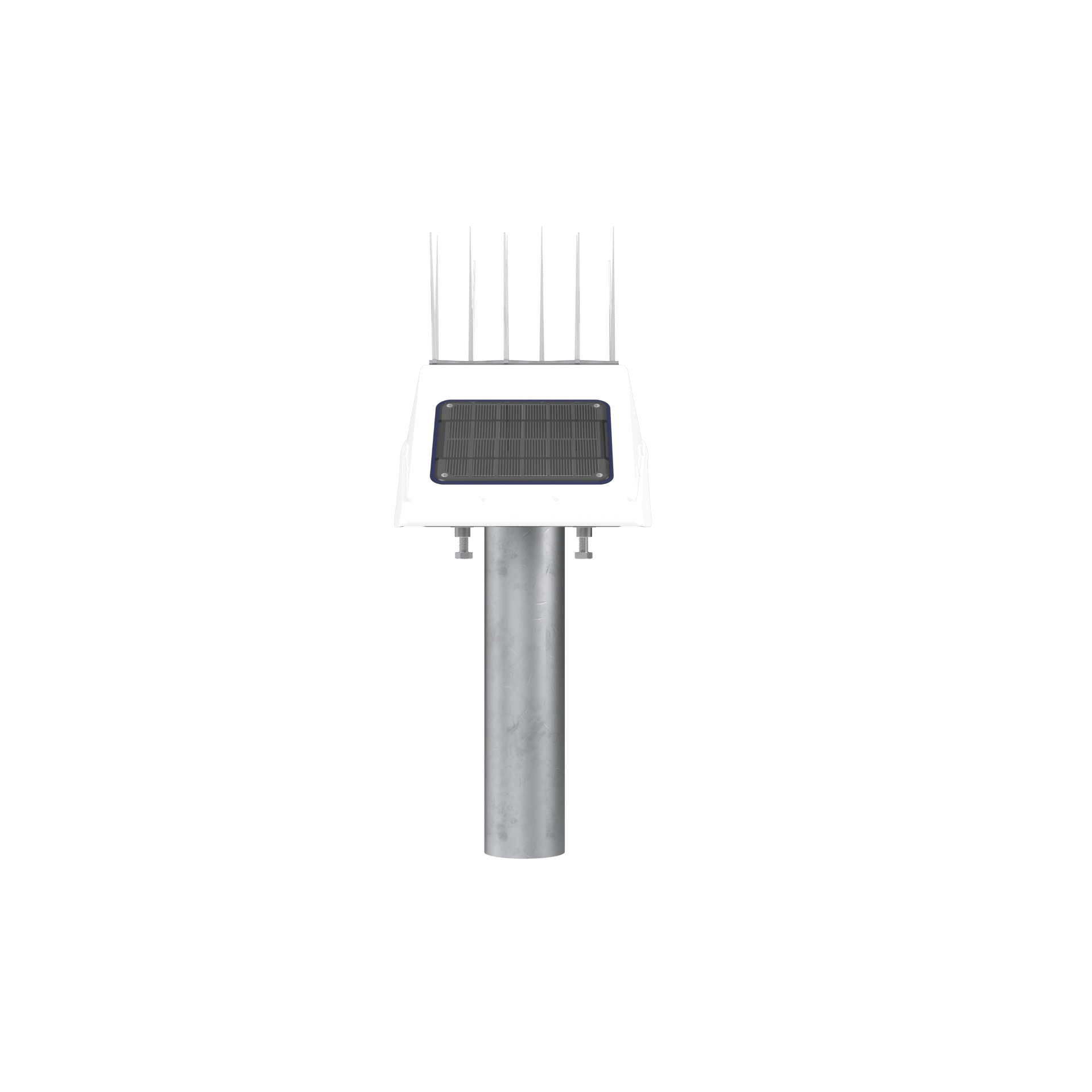

Autonomous settlement tracking equipment, Basetime Locator One device, used for De Wieden dike monitoring in the wetlands of St. Jansklooster.

The project provided early and reliable insight into settlement and object movement, enabling faster execution and reducing liability risks.

Project Purpose

The project aimed to identify soil settlement, compaction and object movement at an early stage, ensuring optimal planning and execution of the road works. By monitoring multiple infrastructure assets through a unified system, detailed insight was obtained into subsurface processes as well as the structural behavior of the bridge and pipeline.

Implemented Solution

Settlement rods and Locator One units were deployed to achieve high-precision positioning of soil layers, structures and pipeline routes. All sensors reported through the same platform, supported by multiple reference stations. Measurement frequency was configured per sub-area, ranging from one to twenty-four measurements per day. This provided a consistent and timely picture of current and future settlement.

Key Results

Technical Requirements

Early insight accelerated project execution.

Direct visibility into settlement and object movements.

Adjacent infrastructure monitored through a unified system.

N

Number of Locator One units: 400

N

Measurement frequency: 1 - 24 measurements per day

N

Accuracy: position 2 mm, height 5 mm

N

Baseline length: approx. 4,000 meters

N

Reference station: multiple

N

Logging time: 2 - 5 minutes
